Crisis at the Dam des Mousseaux: problems and solutions
FEBRUARY 2025
STOP PRESS:
REUNION SUR LE BARRAGE
le 26 fevrier, 19.00 h
Salle Publique a Meon
Reunion Publique
Pour plus des renseignements contactez Mairie de Breil.
0241 825518
The Problems Created by the Resurgence at the Foot of the Dam: September 2021 to Present
Around 13th September 2021 a resurgence or spring suddenly appeared at the downstream foot of the dam. This was notified by SYDEVA (Syndicat pour le developpement de l'Authion) on 20 September 2021 and also to the Direction Regionale de l'Environnement de l'Amenagement de du Logement (DREAL) of the Pays de la Loire as it presented a potential danger.
But the springs were suppressed by the construction and have presented few problems in the past 50 years, other than in the ground being very humid. Excess water is mostly carried away in the canal which takes the water back to the Lathan after the diversoire.
But around 13th September, 2021, when a piezometric borehole was drilled at the foot of the dam as part of investigations recommended by an approved consultancy firm, the drilling caused a resurgence of pressurised groundwater which rose to the surface. The finding in September 2021 was that the water that came out was clear and free of fine particles, which meant it was not causing any noticeable erosion of the dam's interior.
On 9th June 2022 SYDEVA was asked to submit a preliminary project for reinforcing the dam by 30 September 2022 and to submit a project by 31 March 2023, requesting that the resurgence be dealt with within 3 months. This was later revised to 30th Jue 2024 following the cancellation of the first project contract and an inspection by DREAL on 12th December 2023.
The launch of the second contract was delayed by the need to treat the resurgence as a matter of urgency as the transport of fine particulate matter had now been observed in the spring water since March 2024.
Fine Particles
The study steering committee meeting of the 2nd April 2024, reported that there had been a worsening of the resurgence, with the appearance of fine particles in the water discharged and a flow rate that has
increased since the winter of 2024. At the time, the design office was working on a solution to fill the borehole with resin.
However, there were fears that the techniques proposed had never been used before and potentially that if it was unsuccessful, the situation would be worse than before. SYDEVA stated that the leakage rate was constant at around 8.5 m3/h; and that the water was still laden with “fines”, and with sandy materials most likely originating from the
foundation of the dam.
A study steering committee on 6th June 2024 proposed :
a first phase of emergency works including the construction of of an access track to the said resurgence, the removal of the concrete base and the capping of the existing piezometer, with a drainage filter, a system for collecting the water and conveying it to atreatment plant; and to a collection manhole and then to a device for measuring water flow rates and water quality and fine particles;
a second phase of emergency work involving the complete restoration of the resurgence
The work started in September 2024 to take advantage of the low-water level of the dam reservoir and the water table,
necessary for the work to be carried out properly, thanks to the lower water pressure in the resurgence at this time of year.
January 2025
This is what happens when earth dams breach. Let's hope it never occurs here!
The Importance of the Work
Without the work, the dam does represent a considerable risk to people downstream in the event of failure.
The water and fines emanating from the resurgence may, if not controlled by the first phase of emergency works, cause a rupture of the foundation soil likely to generate untimely releases of water without it being possible to intervene to stop them, and that this situation is likely to degenerate into a breach in the dam.
According to the most recent hazard study on the dam, in the event of a full-load failure, the failure wave would affect the entire dam, including the reservoir. and the rupture wave would affect around 605 buildings and 1,278 people, including 70 who would be rapidly exposed in Breil (less than 45 minutes), and including 2 schools in Longué-Jumelles.
It was concluded that if the migration of fine materials has not been controlled after 21 June 2024, despite the first
of the work, SYDEVA, as the legal manager of the Rillé dam, would proceed immediately to conduct an emergency draining of the Rillé dam, by lowering the water level by 1 m per week, or failing that, opening the dam gates completely, from the day on which the presence of fines in the water collected downstream of the temporary works is observed or completely stopped, or until the dam is completely emptied.
Currently although the resurgence itself has not been suppressed, the current actions have meant that fine particles are not at present observed. Accordingly, the water level of the dam will be drained in accordance with the normal operation of the dam and the studies continue, with possibly a future ‘vidange’ of the lake next year or soon after, so other remedial works can be done and the condition of the dam and surrounding structures can be examined.
A meeting is to be held for local people in Noyant in February. (Give details here when known)
IMAGES

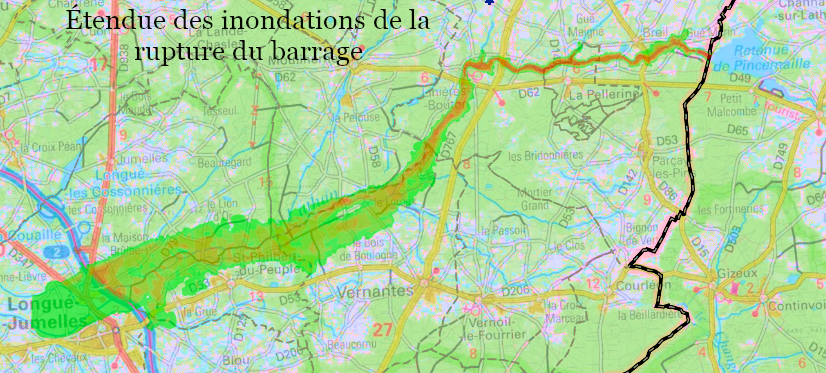

Post dam breach map
The latest disaster analysis showed that a huge area would be affected within a short while after a breach of the dam

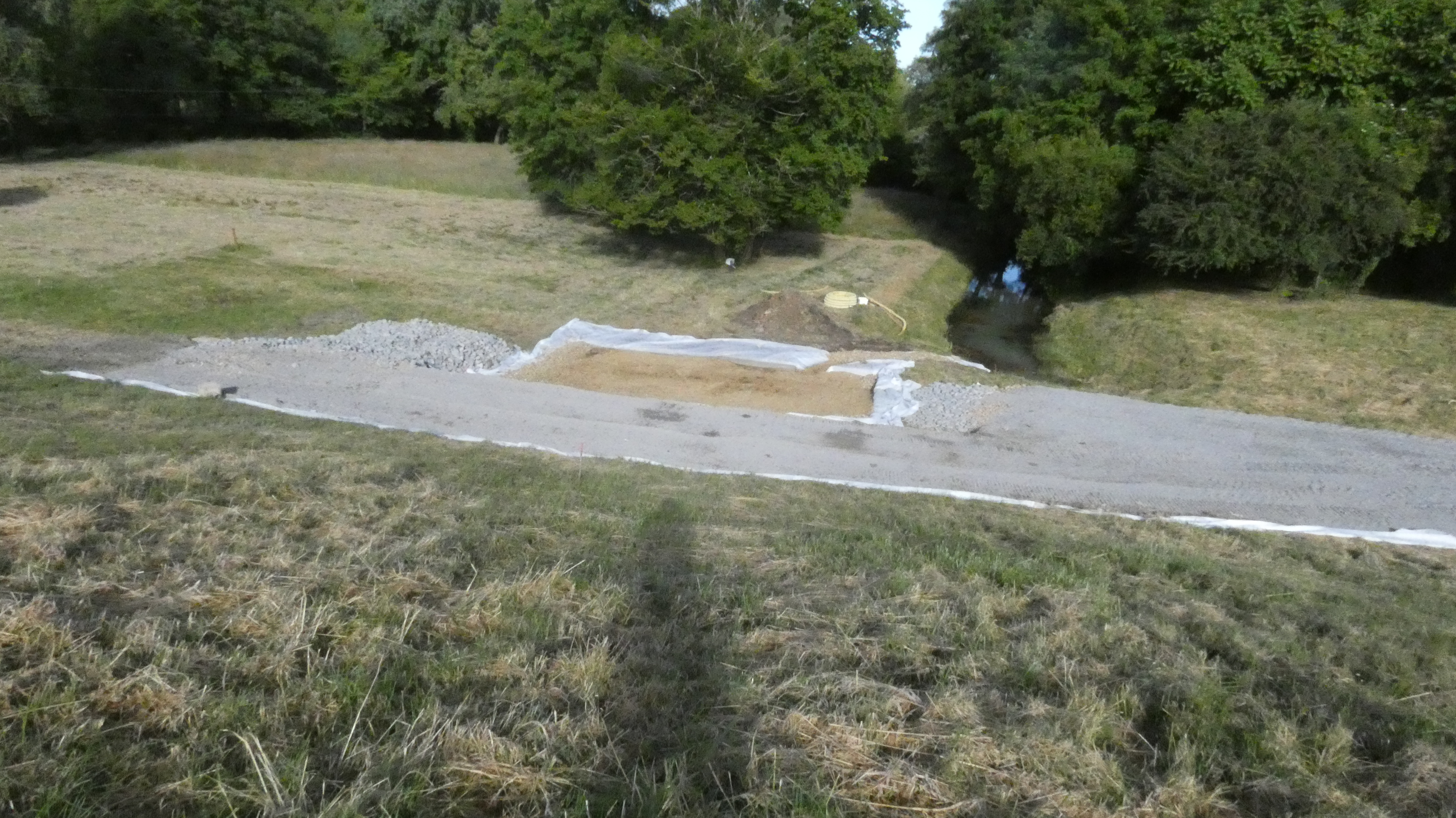

Gravel Bed to Suppress Resurgence
Although the new gravel bed with membranes and other structures has not repressed the spring, the water currently is free from fine particles reducing past concerns

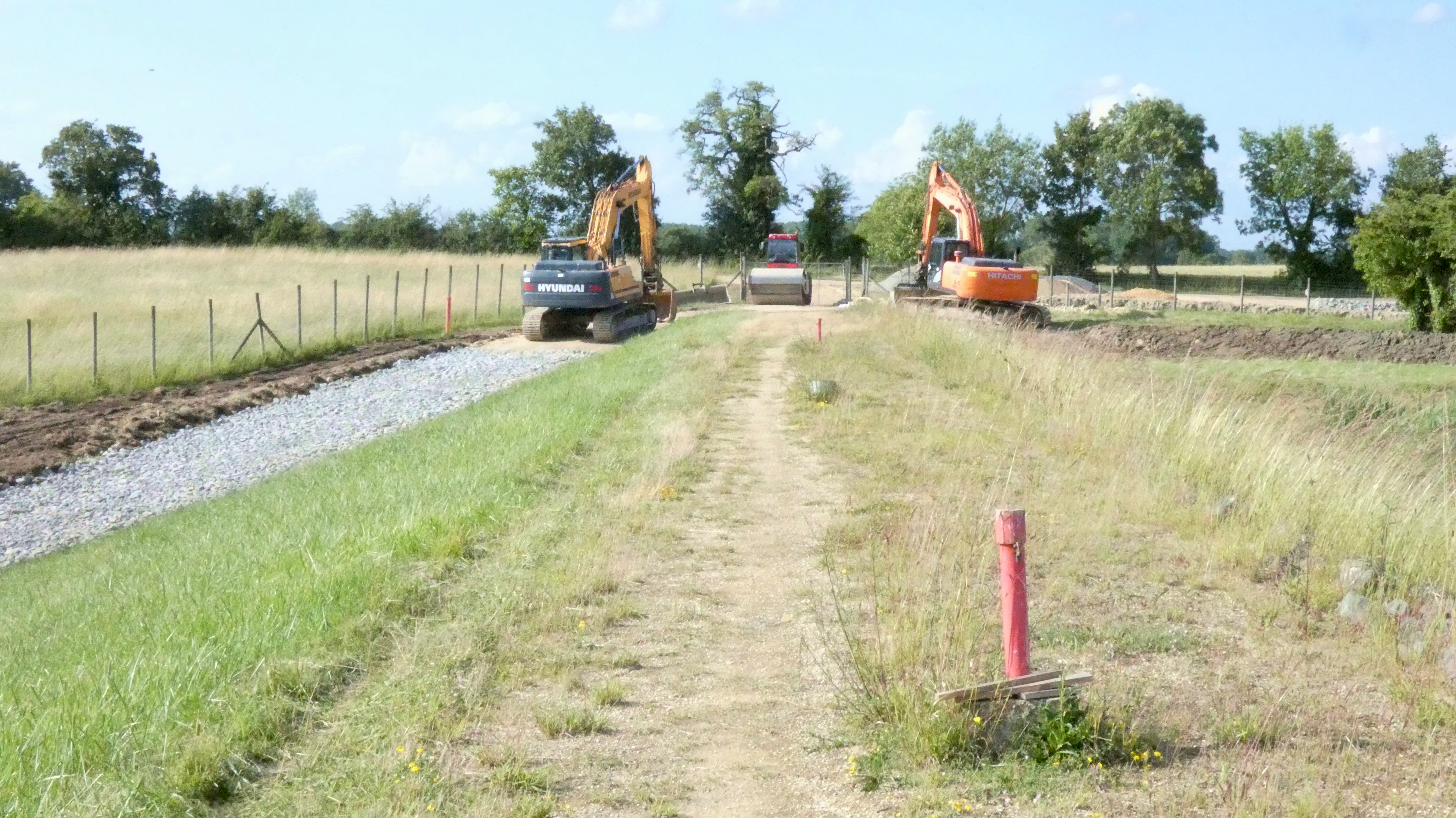

The New Access Road
The new road was built across the face of the dam and to the foot at the downward side. This means heavy machinery can now easily access for remedial work

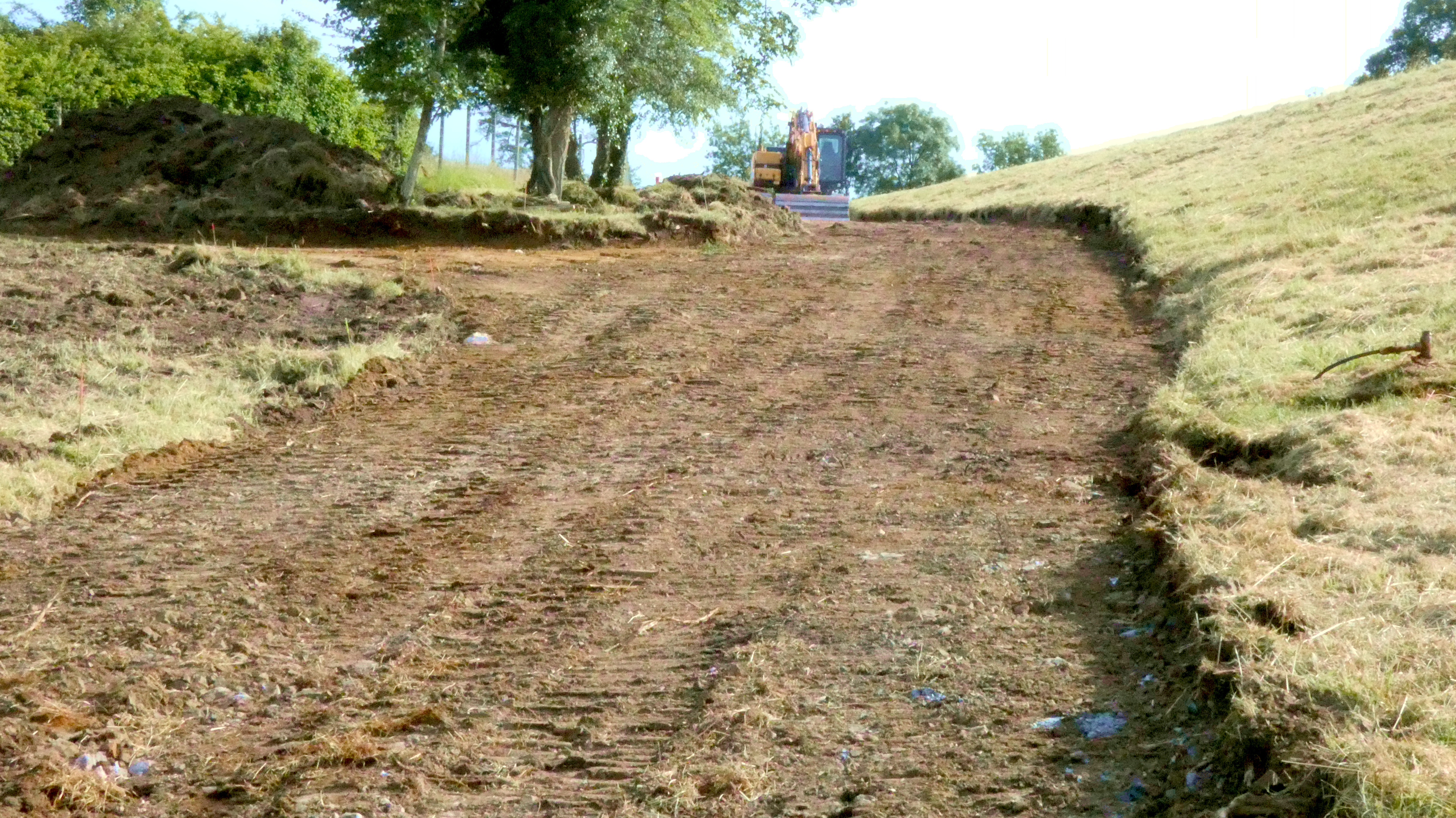

Initial Road Work
There was substantial work involved in created a foundation for the new road for heavy machines across the front of the dam

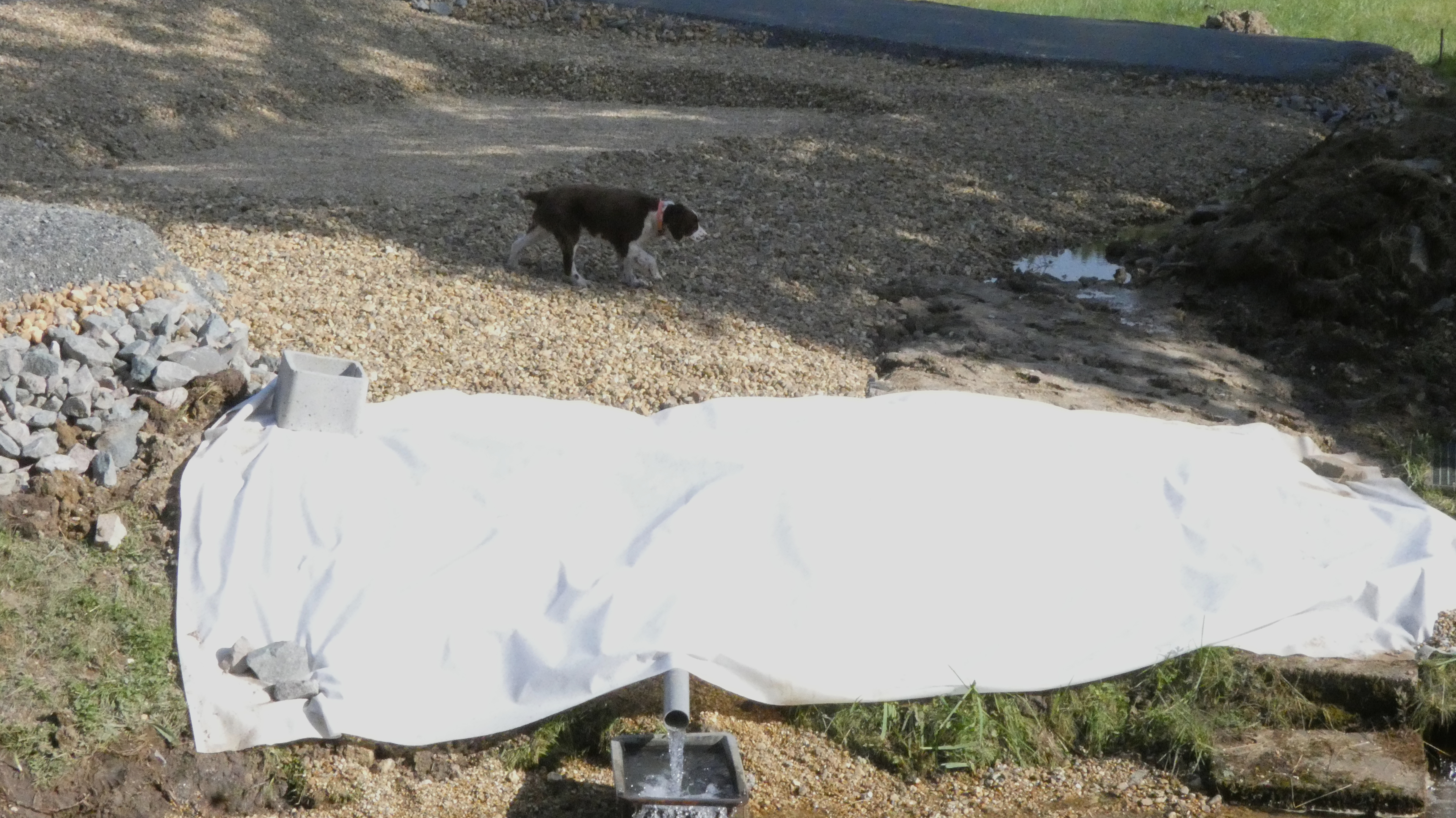

Large membranes suppress particles present in the spring water
New membranes are designed to suppress fine particles present in the spring or resurgence water. This should prevent the particles being removed from the structure of the dam eventually weakening it.

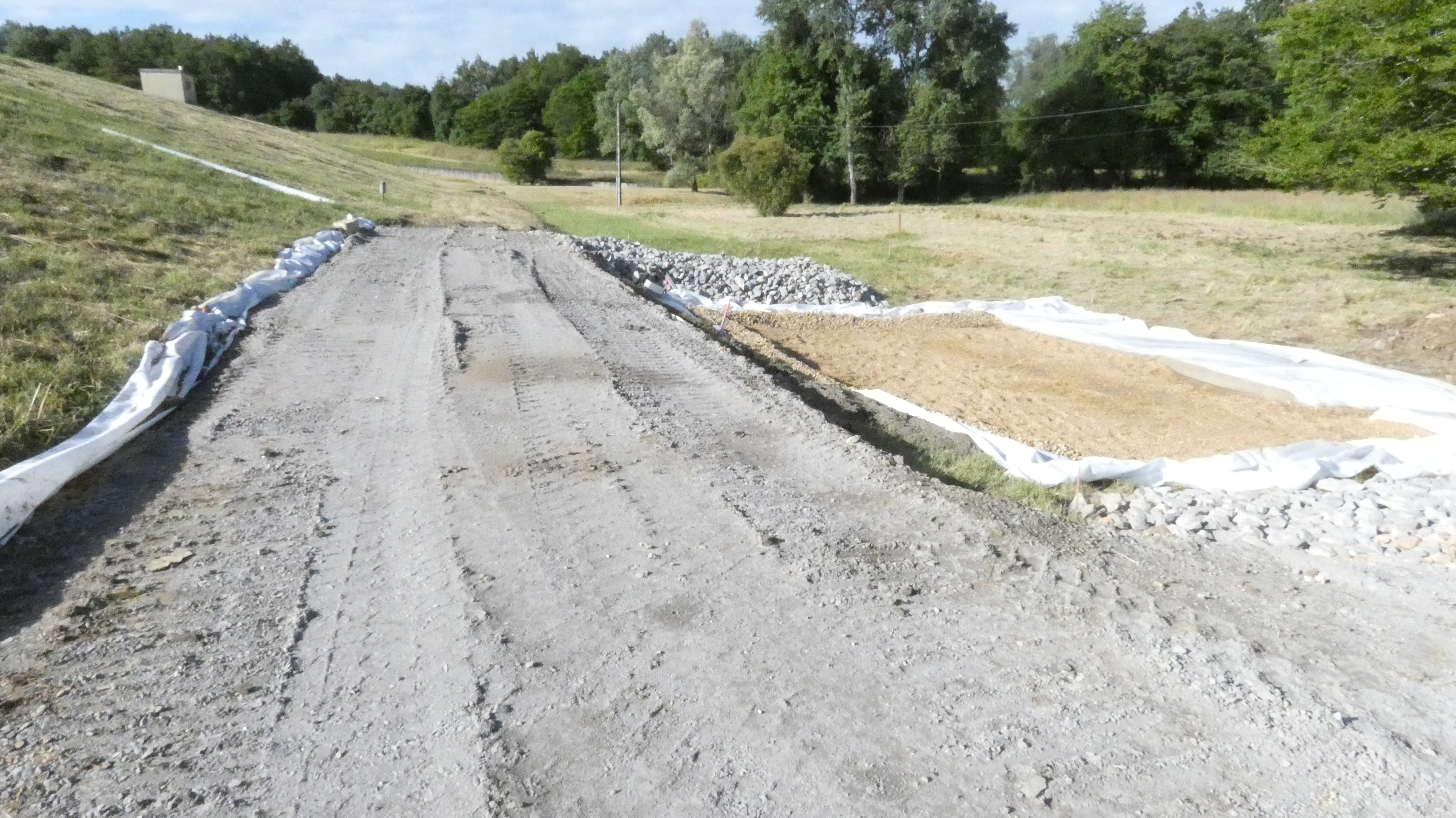

New gravel bed at the foot of the dam
The gravel bed surrounded by the road way is where a new well has been placed to suppress the flow and control the emerging water.

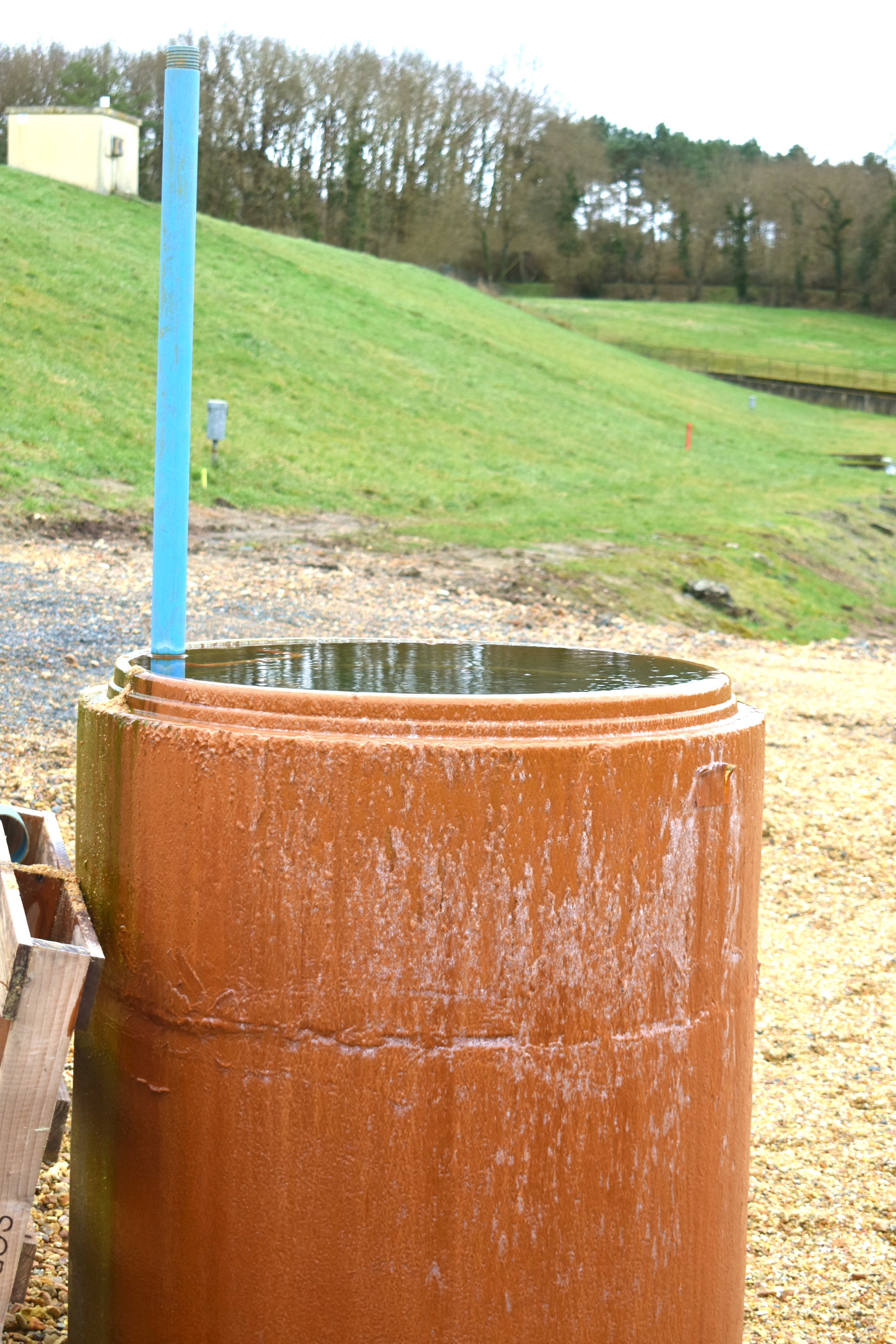

Latest equipment to measure resurgence outlet
A new well is installed into which the spring water rises and this enables regular monitoring for fine particulates. It is full to the brim

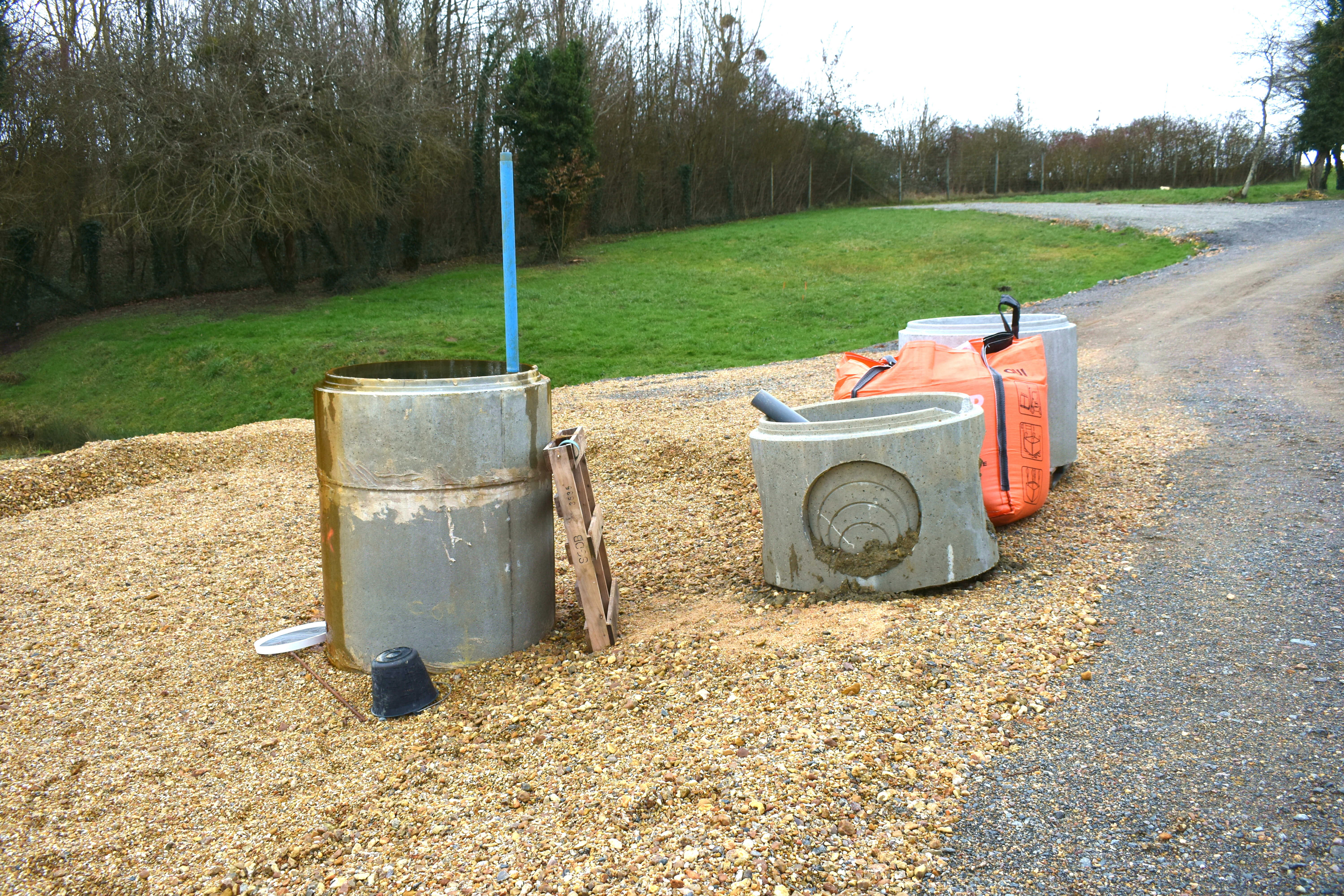

The new well with resurgence outlet in which spring water rises
A new well is installed into which the spring water rises and this enables regular monitoring for fine particulates. It is full to the brim. The water is warm
